Highway Legislation in the UK – A Developer’s Guide

A Practical Guide for Developers and Contractors

Highway legislation in the UK plays a key role in how new developments connect to existing roads, how private streets become public highways, and how structures such as retaining walls are controlled and approved.

For developers, getting this wrong can lead to delays, redesigns, or costly remedial works. This guide explains the most common areas of highway legislation that affect development projects, with a focus on Sections 38 and 278 of the Highways Act 1980, and the rules around highway retaining walls. While much of the process is similar across the UK, there are important legal differences between England and Wales, Scotland, and Northern Ireland.

This guide has been prepared by Matrix Consulting Engineers, who regularly support schemes across the UK through highway design, approvals, and technical assurance.

Aerial view of a modern residential neighbourhood with rows of red brick houses, driveways, cars parked, and fenced back gardens.

Construction of New Public Highways

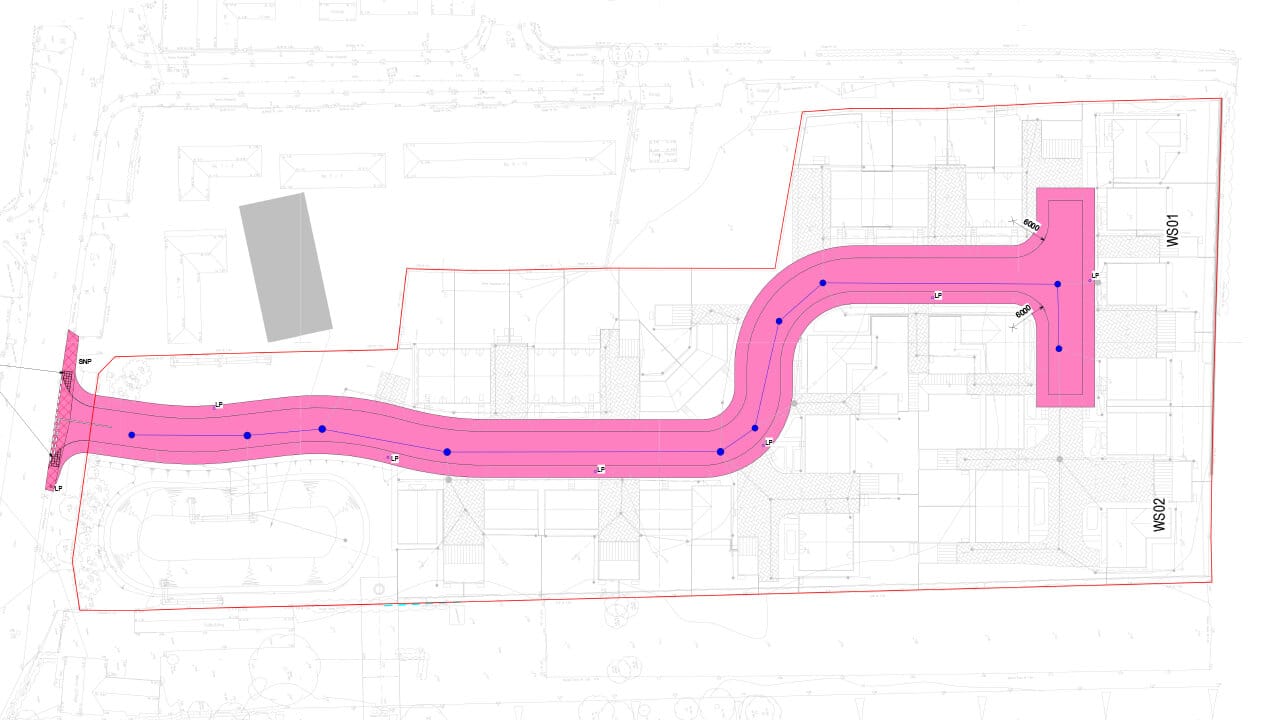

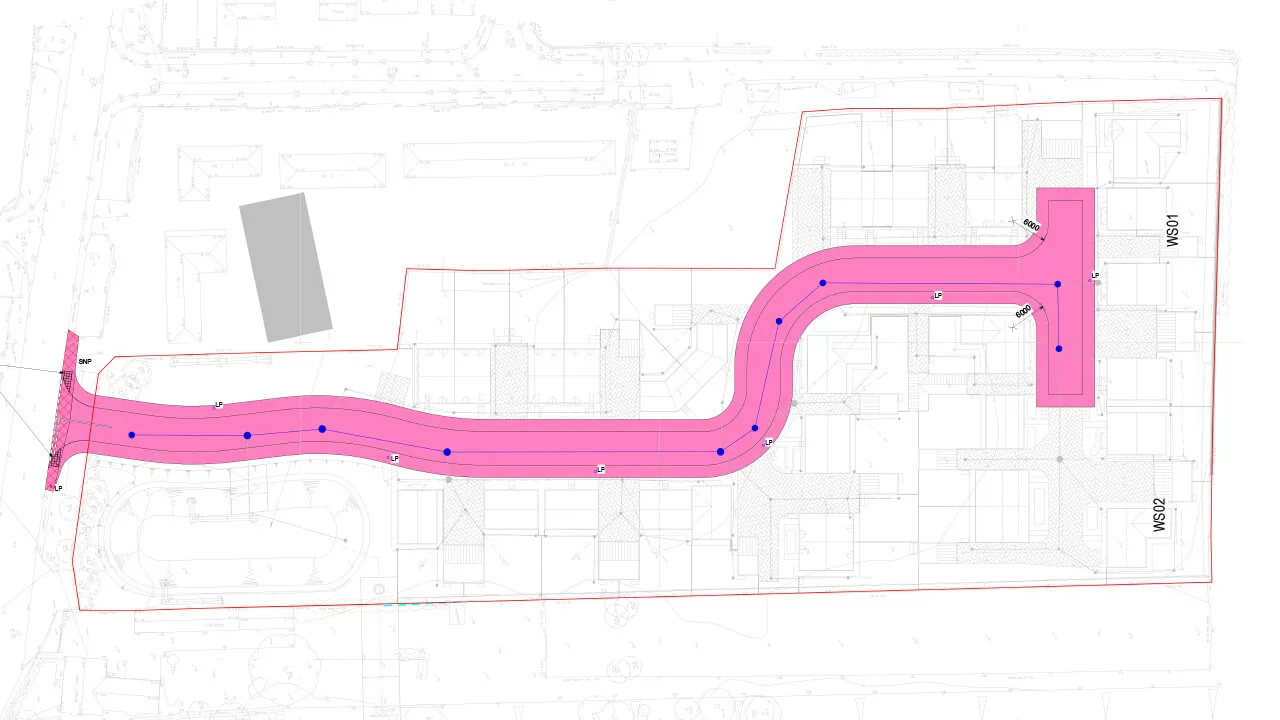

Site plan showing a curved pink path with blue markers running through a building layout, enclosed by a red boundary line, labelled as L001 and L002.

What Is a Section 38 Agreement?

A Section 38 Agreement is used when a developer wants a new road, built as part of a development, to be adopted by the local highway authority.

Under Section 38 of the Highways Act 1980, the highway authority may enter into an agreement with a developer where:

Once adopted, the road becomes maintainable at public expense, meaning future upkeep is handled by the highway authority rather than residents or a management company.

Key Points Developers Need to Know

Section 38 agreements are often required before construction starts on site and will typically involve detailed technical approval, inspections, and staged sign-off.

Scotland Side Note

Scotland does not use Section 38 agreements. Instead, new roads are dealt with under the Roads (Scotland) Act 1984, through a process known as Road Construction Consent (RCC). Approval is granted before construction begins and adoption is linked directly to consent conditions. Roads authorities have stronger enforcement powers, so early engagement is essential.

Northern Ireland Side Note

Northern Ireland does not use Section 38 agreements. New roads are adopted through private street determinations under the Private Streets (Northern Ireland) Order 1980, overseen by the Department for Infrastructure. Adoption is controlled centrally, and timescales can be longer due to this central approval process.

Changes to Existing Public Highways

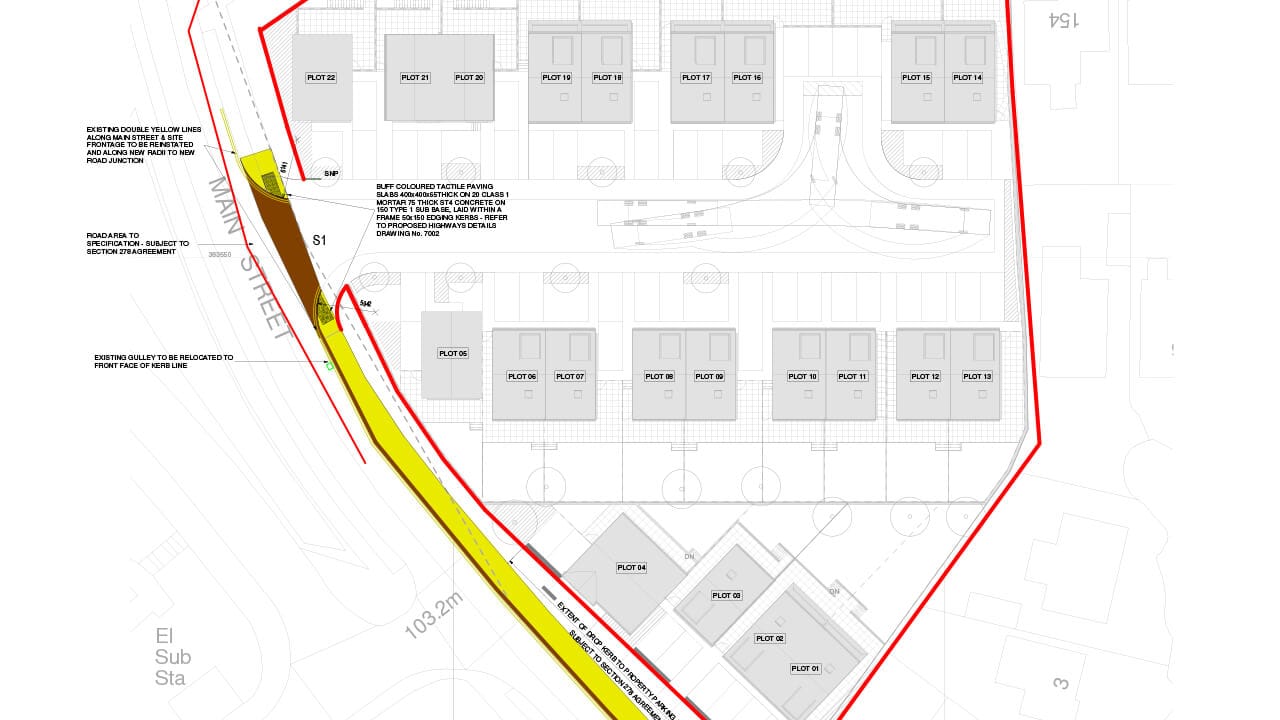

Site plan showing a housing development layout with plots, roads, pathways, boundary lines, and annotations for construction and landscaping details.

What Is a Section 278 Agreement?

Section 278 Agreement allows developers to make changes to the existing public highway to support their development. Under Section 278 of the Highways Act 1980, a highway authority may enter into an agreement with a developer to fund highway works, construct highway works, or both.

These works usually sit outside the red line boundary of the development site but are required to make the scheme acceptable.

What Is a Section 278 Agreement commonly used for?

Unlike Section 38, the works are carried out on an existing adopted highway, which means strict controls, approvals, and safety procedures apply.

Why Section 278 Matters

Without a signed Section 278 agreement, planning conditions may not be discharged, occupation of the site can be delayed, and the local authority may refuse access works. Early engineering input is critical to avoid late-stage changes and programme risk.

Scotland & Northern Ireland Side Note

Neither Scotland nor Northern Ireland use Section 278 agreements. Highway works are instead secured through planning conditions and direct works agreements. In Scotland, all works on public roads require written consent and many authorities require approved contractors. In Northern Ireland, works are delivered under agreements with the Department for Infrastructure, with higher reliance on direct departmental oversight.

Highway Retaining Walls

Legal Definition and Responsibilities

Under Section 167(9) of the Highways Act 1980, a retaining wall is defined as:
‘A wall, not forming part of a permanent building, which serves or is intended to serve as support for earth or material on one side only.’

Retaining walls near or within highways are closely controlled due to the risk they pose to public safety and the road network.

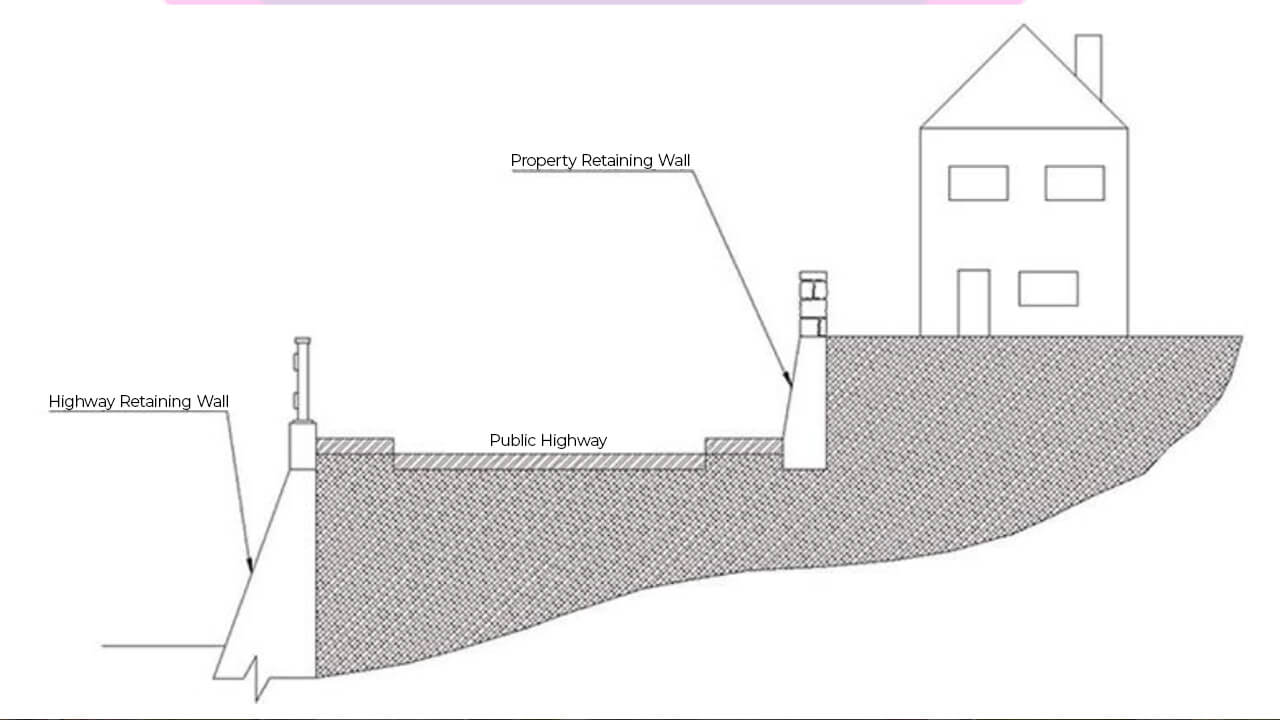

Diagram showing a house on raised land, with labelled Property Retaining Wall supporting the house and Highway Retaining Wall supporting the public highway below.

Types of Retaining Walls Near Highways

Retaining walls within or close to highway land usually fall into one of two categories:

Highway Retaining Walls

These support the highway itself or an embankment that carries the highway. They are often the responsibility of the highway authority once adopted and are treated as highway structures subject to strict design and approval standards.

Property Retaining Walls

These sit alongside the highway, are usually above road level, and are generally private structures. Responsibility typically remains with the landowner, even though failure could still affect the highway.

Approval of Highway Retaining Wall

Under Section 167(1) of the Highways Act 1980, a retaining wall requires formal approval if it is within 3.66 metres (4 yards) of the highway boundary and the retained height exceeds 1.37 metres (4 feet 6 inches). This may vary, however, depending on the adopting body.

In these cases, the structure must go through an Approval in Principle (AIP) process.

What the AIP Process Involves

Many highway authorities apply a stricter rule, treating any wall over 1.5 metres as a highway structure regardless of location. Failure to secure approval can result in enforcement action or a requirement to remove or rebuild the structure.

Scotland & Northern Ireland Side Note

Neither jurisdiction uses the AIP process as defined in England and Wales. In Scotland, structural approval is secured through RCC conditions with independent checking. In Northern Ireland, designs are reviewed by the Department for Infrastructure, with approval thresholds set by internal guidance. Responsibility remains with the developer unless formally adopted in both cases.

Practical Implications for Construction Management

For construction professionals, shrinkable soils affect more than just foundation design. They have implications for:

Early site investigation and clear communication between designers, contractors, and clients are essential. Decisions made at the concept or planning stage can prevent major issues years after project completion.

Frequently Asked Questions (FAQs)

Section 38 deals with new roads being built and adopted as public highway. Section 278 deals with changes to existing public roads to accommodate a development. Many sites require both.

No. They apply only in England and Wales. Scotland uses the Roads (Scotland) Act 1984, and Northern Ireland uses the Private Streets (Northern Ireland) Order 1980. Different approval routes apply in each nation.

Yes — this is very common. Many sites require new estate roads under Section 38 and off-site junction improvements or pedestrian infrastructure under Section 278. Both agreements run in parallel and both affect programme.

Before adoption, the road remains private. Maintenance is the developer’s responsibility. This includes pothole repair, drainage, and lighting — costs that can be significant on larger schemes.

In England and Wales, this is typically when the wall supports the highway, exceeds the height limit of 1.37m, or sits within 3.66m of the highway boundary. Many authorities apply a 1.5m threshold regardless of proximity. Local rules can vary, so early consultation is recommended.

Highway legislation affects planning approval, construction cost, programme risk, and long-term liability. Early input allows designers to identify the right agreements, prepare compliant drawings first time, and avoid costly redesigns or enforcement action downstream.

Final Thoughts

Although highway legislation follows similar principles across the UK, the legal routes are different. Understanding which system applies is essential for safe, compliant, and timely delivery.

Matrix Consulting Engineers support clients across England, Wales, Scotland, and Northern Ireland, providing clear advice from early design through to approval and construction.

Why Early Engineering Advice Matters

Highway legislation affects planning, cost, safety, and programme. Engaging civil and structural engineers early allows developers to:

At Matrix Consulting Engineers, highway legislation is considered from the earliest design stage through to construction and adoption.
